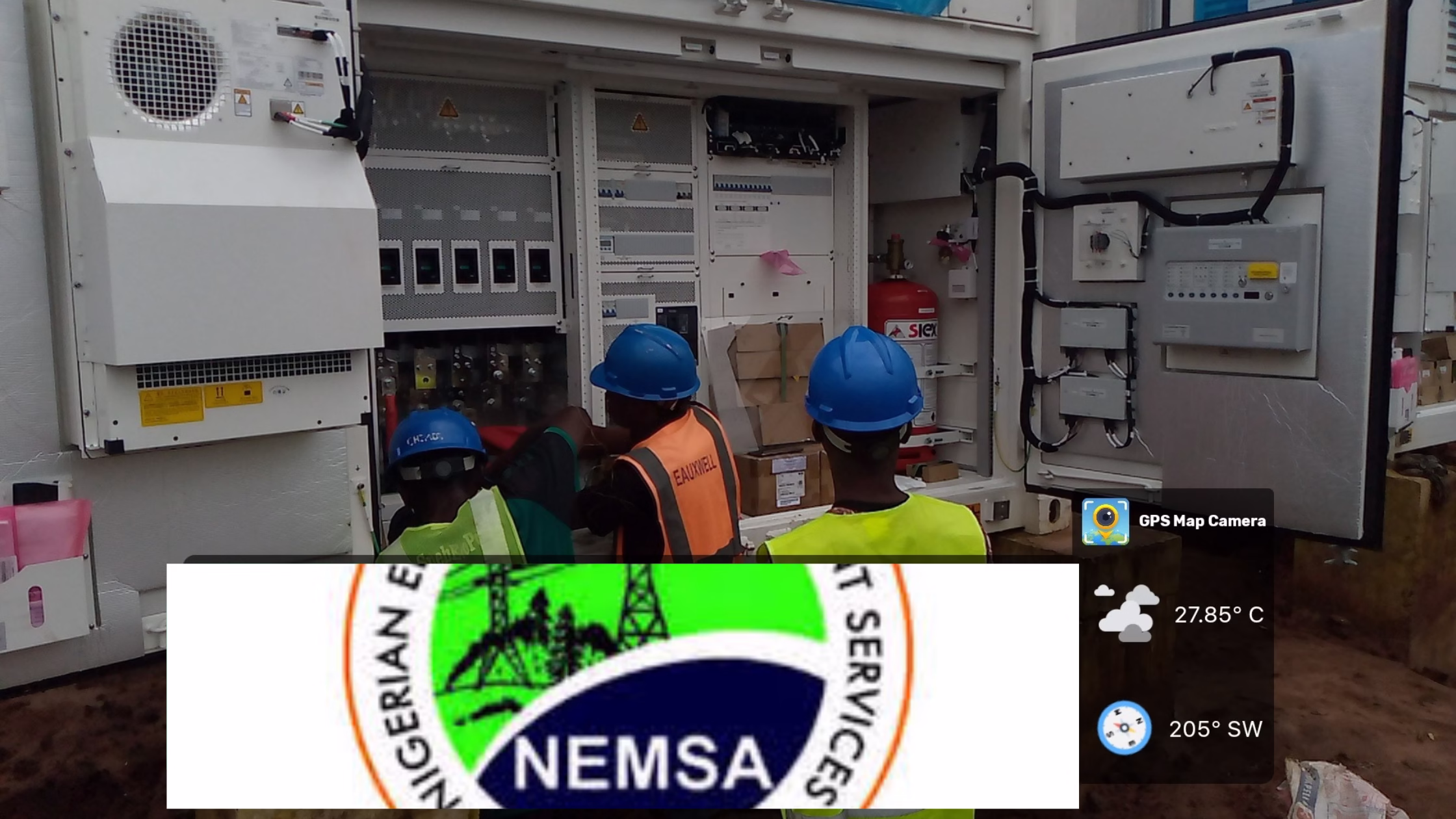

NEMSA Inspection Checklist: How to Prepare Your Solar Power Plant for Certification

As Nigeria expands its renewable energy footprint, solar hybrid power plants are becoming critical parts of the nation’s energy infrastructure. But before any solar project can be connected to the national grid or officially commissioned, it must first pass through one crucial stage — NEMSA inspection and certification.

If you’re a Lead Resident Engineer, Project Manager, or EPC contractor, this guide will show you everything you need to prepare for a NEMSA site visit, including a comprehensive pre-inspection checklist designed specifically for large-scale solar hybrid projects.

 What is NEMSA and Why the Inspection Matters

The Nigerian Electricity Management Services Agency (NEMSA) is the authority responsible for ensuring that all electrical installations in Nigeria are safe, technically sound, and compliant with national standards.

For any 7.2MW solar hybrid power plant or similar project, NEMSA’s inspection is not a formality — it is a legal and technical requirement before energization or grid connection.

A successful inspection leads to the issuance of the Certificate of Electrical Fitness for Use, the official document confirming your plant’s readiness for operation. Without it, your project cannot legally be energized or handed over.

Objectives of NEMSA’s Inspection

During their visit, NEMSA engineers verify that:

  • All electrical installations comply with NESIS and IEC standards.
  • The earthing and lightning protection systems are effective.
  • Proper protection, control, and interlock systems are installed.
  • All testing, documentation, and safety records are accurate.
  • The plant is safe for operation and free of electrical hazards.

In short, they confirm that your solar power plant is built to perform safely and reliably under real-world operating conditions.

Key Areas NEMSA Will Inspect

As the Lead Resident Engineer, you should expect NEMSA to focus on these major sections of your project:

  1. Earthing and Lightning Protection

They will measure earth resistance values across all major equipment — PV arrays, inverters, transformers, and switchboards. Each pit must be properly labeled, and lightning protection systems must be bonded to the main earth grid.

  1. Cables and Terminations

Inspectors will check that all AC and DC cables are sized correctly, properly routed, and securely terminated. Loose or exposed cables are major red flags.

  1. Electrical Panels and Protection

Inverter panels, LV/MV switchboards, breakers, and isolators must be labeled, rated correctly, and free from any physical or wiring defects.

  1. Control and SCADA System

The SCADA and protection system must demonstrate accurate monitoring, alarm signaling, and remote shutdown capability. Anti-islanding protection will be tested to ensure the system isolates from the grid when needed.

  1. Testing and Measurement

NEMSA will review or witness electrical tests such as continuity, insulation resistance, polarity, and relay testing. Always keep your test reports neatly filed and signed off by certified personnel.

Documents NEMSA Will Request

Before the inspection, gather and organize the following documents:

  • Approved Single Line Diagrams (SLDs) and as-built drawings
  • Earthing and lightning layouts with measured resistance values
  • Factory Acceptance Test (FAT) and Pre-Commissioning Test Reports
  • Equipment datasheets, calibration certificates, and QA/QC logs
  • Protection coordination studies and relay settings
  • Licenses of engineers and contractors involved in the installation

Having these ready shows professionalism and speeds up the certification process.

The Complete NEMSA Pre-Inspection Checklist

Use this checklist to ensure your site is fully compliant before NEMSA arrives:

🔹 1. General Site Readiness

  • Access roads and inspection areas are clear.
  • Safety signage and “High Voltage” warnings displayed.
  • Fire extinguishers and first aid kits are available.
  • Proper housekeeping — no exposed or loose cables.
  • AC/DC circuits clearly separated and labeled.

🔹 2. Documentation

  • All electrical drawings, SLDs, and test reports available.
  • Calibration and safety certificates up to date.
  • QA/QC and NCR records completed.

🔹 3. Earthing & Lightning System

  • Earth resistance ≤ 1Ω or as per NEMSA standard.
  • Pits numbered and linked to layout plan.
  • Earth conductors ≥ 70mm² and properly tagged.
  • LPS connected to the main grid and continuity verified.

🔹 4. PV Array Yard

  • Each array section labeled with unique ID.
  • Combiner boxes, fuses, and connectors secure.
  • Cable dressing neat, with excess lengths removed.
  • Polarity tests completed and results recorded.

🔹 5. Inverter & Control Rooms

  • Panels installed and grounded.
  • Breakers, isolators, and MCCBs correctly rated.
  • Functional trip and alarm tests completed.
  • Inverter-SCADA communication tested and verified.

🔹 6. Transformer & MV Switchgear

  • Transformer nameplates match design.
  • Proper earthing of tank and neutral points.
  • MV panel interlocks and relays tested.

🔹 7. Testing and Commissioning

  • Insulation resistance, continuity, and polarity tests documented.
  • Earth resistance and relay test reports available.
  • Load and functional test results certified by QA/QC.

Your Role as the Lead Resident Engineer

As the site’s lead engineer, you serve as the technical focal point during the inspection. Your duties include:

  • Coordinating and accompanying the NEMSA inspection team.
  • Explaining the operation and protection philosophy of the plant.
  • Presenting all relevant documentation and reports.
  • Recording observations and ensuring corrective actions are taken promptly.
  • Ensuring site safety and professionalism throughout the visit.

A confident, well-prepared site engineer helps build credibility and trust with inspectors.

After the Inspection: What Comes Next

Following the inspection, NEMSA will issue an Observation or Recommendation Report highlighting any non-conformities.
Once all corrective actions are implemented and verified, NEMSA issues the Certificate of Electrical Fitness for Use — the final authorization for your solar plant to operate or connect to the grid.

Without this certificate, your project cannot legally be energized, handed over, or insured.

Final Thoughts

Preparing for a NEMSA inspection isn’t just about ticking boxes — it’s about demonstrating technical excellence, safety, and compliance. A well-prepared solar power plant reflects the integrity of its engineers and contractors.

When your documentation is complete, your tests are accurate, and your site is orderly, the NEMSA team’s job becomes smoother — and your certification comes faster.

Quick Summary: What to Remember

Focus AreaKey Check
EarthingResistance values ≤ 1Ω, proper bonding
LPSCoverage verified and tagged
PanelsTight terminations, correct labels
SCADAData transfer and trip logic tested
DocumentationSLDs, test reports, and QA records ready
SafetyPPE, fire extinguishers, clear signage



EXAMPLE OF NEMSA PRE-INSPECTION CHECKLIST

Project: 7.2 MW Solar Hybrid Power Plant
Location: ___________________________
Date of Inspection: __________________
Prepared by: Lead Resident Engineer (Electrical)
Signature: __________________________

 1. General Site Readiness

S/NItemRequirementStatus (OK/Not OK)Remarks
1Site access roads cleared and safeAll inspection points easily accessible
2Safety signage and danger notices displayed“Danger – High Voltage”, “Authorized Personnel Only”, etc.
3Fire extinguishers provided and inspectedAt inverter stations, control room, transformer bay
4First-aid box and safety PPE availableFor all personnel
5Site housekeepingNo debris, exposed cables, or obstructions
6AC/DC segregation clearly markedSeparate conduits and trunking labeled

2. Documentation & Drawings

S/NDocumentAvailable (Yes/No)Remarks
1Approved Single Line Diagram (SLD)
2As-Built Drawings (electrical, civil, mechanical)
3Earthing layout with pit locations and test values
4Lightning protection layout
5Equipment datasheets and test certificates (FAT)
6Pre-commissioning test reports (IR, continuity, etc.)
7Calibration certificates for testing instruments
8Contractor and supervising engineer licenses
9QA/QC records and NCR close-out
10Safety & commissioning procedure

 3. Earthing System Verification

S/NCheck ItemRequirementStatusRemarks
1Earth resistance values≤ 1 Ω for main earth grid; per NEMSA spec for other points
2Earth pits labeled and recordedUnique IDs with resistance readings
3Earth conductors sizing70 mm² Cu min. (or per design)
4Bonding of metallic structuresPV frames, support rails, fences bonded
5Earth continuity test completedRecorded and verified

 4. Lightning Protection System (LPS)

S/NCheck ItemRequirementStatusRemarks
1Air terminals installed at all PV zonesCoverage verified
2Down conductors properly routed & protectedNo sharp bends; tagged
3LPS bonding to main earth gridContinuity confirmed
4Surge protection devices (SPD) in panelsCorrect ratings and orientation



5. PV Field / Array Yard

S/NCheck ItemRequirementStatusRemarks
1Array sections properly numberedSectionalization labels installed
2Combiner boxes secured & labeledIDs correspond to SLD
3String fuses and connectors inspectedTight, corrosion-free
4DC cable terminationsCorrect polarity, crimping, insulation intact
5Cable routingProper dressing, supported, and protected
6Excess cable length removedCoiling avoided

 6. Inverter & Control Rooms

S/NCheck ItemRequirementStatusRemarks
1Inverter panels installed and earthedAs per manufacturer guide
2LV switchboards labeledSource, feeder, and breaker IDs
3MCCBs/MCBs rated correctlyPer load schedule
4Isolation points clearly markedDC & AC isolators accessible
5Functional tests completedAlarms, trips, and interlocks
6Inverter-to-SCADA communicationConfirm data transfer and alarms

7. Transformer and MV Switchgear Section

S/NCheck ItemRequirementStatusRemarks
1Transformer nameplate data matches designVoltage ratio, capacity, vector group
2HV/MV terminations tight and insulatedProper lugs, crimping, and phase color
3Oil level and conditionChecked (if oil-filled type)
4Earth connection to tank and neutralVerified continuity
5MV panel functional testsTrip logic, interlocks, indication lamps

8. Protection, Metering & SCADA

S/NCheck ItemRequirementStatusRemarks
1Relay protection schemeSettings approved and coordinated
2CTs and PTs testedRatio and polarity correct
3Energy meters calibratedCertificates available
4SCADA interface operationalAlarms, data logging, trend
5Anti-islanding protection testedVerified trip on grid loss

 9. Testing & Commissioning Reports

S/NTestConductedReport AvailableRemarks
1Continuity test
2Insulation resistance test
3Earth resistance test
4Polarity test (DC)
5Functional & interlock test
6Relay testing
7Load test / performance test

10. Observation and Follow-Up

Observation No.DescriptionResponsible PersonTarget DateStatus

Final Certification

NameRoleSignatureDate
Lead Resident Engineer
QA/QC Engineer
HSE Officer
EPC Contractor Rep.
